Learn PLCs free
Evidence-led guide8 510 words

Advanced Process Control: MPC, APC Layers and Examples

Understand advanced process control from cascade and inferentials through constrained MPC, commissioning, software selection, operator handoff and sustained benefits.

PPI
PLC Programming IO Editorial Team
Sourced guidance with documented review and correction standards

Review status: Editorially reviewed against the ISA advanced-process-control overview and Automation Body of Knowledge scope; Qin and Badgwell's MPC survey and recent peer-reviewed MPC application literature; current official Honeywell, AspenTech, AVEVA, KBC, ABB, Emerson and MathWorks capability pages; NIST SP 800-82 Rev. 3; and US OSHA process-safety-management and hazardous-energy rules. Product capabilities, models, constraints, economic objectives, control authority, tuning, safety functions, cybersecurity controls, licensing, integrations, benefit estimates and acceptance limits remain process-, site-, version-, vendor- and risk-specific

Direct answer

Advanced process control (APC) is the layer of control methods used when well-tuned individual regulatory loops are not enough to keep a process near its best operating region. The term is an umbrella, not one algorithm. It can include cascade, ratio, feedforward, override/selective control, inferential measurements, decoupling, multivariable model predictive control (MPC) and a controlled interface to real-time optimization. A useful APC system coordinates variables, predicts interactions or disturbances, respects operating constraints and returns authority cleanly to the plant's base control system when its prerequisites fail.

APC does not replace instruments, valves, PID loops, interlocks, alarms, a basic process control system (BPCS) or a safety instrumented system (SIS). It depends on those layers. A model cannot repair a sticking valve, a biased analyzer, wrong engineering units or a PID loop left in manual. The first APC decision is therefore a readiness decision: prove measurement quality, final-element response, regulatory-loop stability, material/energy balances, operating modes, constraints, operator ownership and safe fallback before estimating the benefit of a sophisticated controller.

MPC is the best-known APC method because it handles interacting variables and explicit constraints in one repeated calculation. At each execution, an MPC controller uses a dynamic model and current measurements to predict future controlled variables (CVs). It selects a sequence of manipulated-variable (MV) moves that reduces objective error while honoring MV, move-rate and CV constraints. Only the first move is applied; the calculation repeats after new measurements arrive. Disturbance variables (DVs) can improve prediction when their future or current effect is measurable.

A credible project is judged by more than whether the APC status says “on.” It must show that the base loops remain healthy, the intended CVs and MVs are eligible, constraints are correctly prioritized, moves are bounded, operator transitions are understandable, fallback is bumpless, and normalized economic or operating evidence persists after commissioning. Software is only one component of that lifecycle.

Advanced process control room view coordinating process measurements constraints predictions and manipulated variables above stable PID loops
APC coordinates an already credible process-control foundation. Prediction and optimization never remove the need for reliable measurements, final elements, regulatory loops, operator authority and independent protection.

Separate the process-control layers before selecting APC

Keep field, regulatory, supervisory and safety responsibilities explicit

The cleanest architecture begins at the physical process. Instruments measure it; valves, drives and other final elements influence it. Regulatory PID loops reject ordinary disturbances and keep individual variables stable. Advanced regulatory strategies coordinate a small number of loops. MPC coordinates several interacting variables over a prediction horizon. A real-time optimizer may periodically calculate economically preferred targets that remain inside an approved feasible envelope.

Interlocks, permissives, alarms and SIS functions retain their own authorities. They must not depend on an APC solver remaining available. If an APC application writes a setpoint or output target, the receiving BPCS logic must still enforce engineering limits, rate limits, mode eligibility and the approved response to invalid or stale data.

Layer Primary job Typical inputs and outputs Evidence required before APC relies on it Authority boundary
Physical process Convert material and energy Flows, compositions, pressure, temperature, inventory Operating envelope, dynamics and hazards understood Governed by physics and equipment limits
Instrument/final element Measure or influence the process Transmitter values, analyzer results, valve/drive commands Calibration, range, quality, response, fail behavior Device and process design limits
BPCS regulatory control Stabilize individual loops and sequences PID PV/SP/OUT, modes, interlocks Loop performance, scaling, anti-windup, modes and fallback Executes normal control within engineered limits
Advanced regulatory control Coordinate a few related loops Cascade, ratio, feedforward, selectors Interaction and disturbance path proven Supervisory setpoints or bounded outputs
Inferential/soft sensor Estimate a hard-to-measure property Multiple measurements to estimated quality Reference lab/analyzer reconciliation and uncertainty Advisory or controlled use with quality gate
MPC Coordinate multiple interacting variables and constraints CVs, MVs, DVs, model, limits and priorities Model validation and closed-loop eligibility Bounded supervisory moves; BPCS remains able to recover
Real-time optimization Calculate economic targets Prices, yields, equipment and model constraints Objective ownership, data reconciliation and feasibility Supplies targets; must not bypass lower-layer constraints
SIS/protection Reduce risk when hazardous conditions demand action Safety inputs, logic solver and final elements Independent safety lifecycle evidence Never substituted by ordinary APC availability
Layered advanced process control architecture from instruments and PID through advanced regulatory control MPC and real time optimization with an independent safety boundary
The optimization layers may propose increasingly coordinated targets, but the instrumentation, BPCS and independent protection layers remain visible and testable.

Distinguish APC from ordinary PID control

A PID controller reacts to the error for one controlled variable, though cascade and feedforward structures can extend what a regulatory design handles. It does not inherently solve a multivariable constrained optimization problem. MPC predicts the effects of several candidate moves on several CVs, accounts for interaction, and chooses moves subject to explicit limits. This makes MPC useful when pushing one output toward a target would otherwise violate another quality, pressure, temperature, energy or actuator constraint.

The distinction is not “old PID versus smart MPC.” A well-designed MPC application normally sends setpoints to reliable PID loops. Those fast base loops absorb local disturbances and make the higher-level plant response repeatable enough to model. Poor PID performance propagates uncertainty into the model and forces the MPC controller to back away, oscillate, deactivate variables or be abandoned by operators.

Question PID/regulatory loop MPC/APC supervisor
Main scope One principal PV and MV, possibly nested or compensated Multiple CVs, MVs, DVs and constraints
Model Implicit through tuning, or simple feedforward relation Explicit dynamic response model used for prediction
Constraints Usually clamps, selectors, anti-windup and application logic Included in repeated move calculation plus receiving-system limits
Interaction Often handled with loop pairing or decoupling Represented across the multivariable model
Typical execution Faster base-control interval Slower supervisory interval chosen from process dynamics
Failure response Manual/auto, output tracking, designed safe state Drop affected variables or controller, track BPCS, return authority cleanly
Success evidence Stability, disturbance rejection, valve behavior Constraint handling, availability, normalized benefit and operator adoption

Choose the simplest strategy that solves the operating problem

Match control structure to disturbance, interaction and constraint evidence

Do not start by declaring that the plant “needs MPC.” Describe the failure of present control in observable terms: a measured disturbance arrives before the primary PV changes; two product variables compete for the same two manipulated variables; quality is delayed by a laboratory result; an actuator repeatedly saturates; operators manually coordinate several setpoints; or production must be kept against a limiting constraint without crossing it.

The least complex strategy that reliably handles the mechanism is usually easier to commission and sustain. Feedforward plus feedback can reject a measurable disturbance. Cascade can isolate a fast secondary disturbance. Ratio control can maintain material proportion. Override/selective control can protect an operating limit. An inferential can provide a faster quality estimate. MPC becomes compelling when these pairwise structures become difficult to coordinate or when multiple constraints must be considered together.

Strategy Best-fit evidence Main design requirement Common misuse Proof case
Cascade Secondary variable responds earlier than primary Inner loop substantially faster and dependable Adding a slow or noisy inner loop Inner disturbance rejected while outer PV remains controlled
Feedforward + feedback Disturbance is measurable before its effect Stable disturbance-to-output relationship and feedback trim Trusting an unmeasured or changing relationship Matched disturbance with and without feedforward
Ratio control One flow/quantity should follow another Correct basis, scaling, limits and low-flow behavior Dividing by a noisy near-zero signal Ratio maintained through master-flow change and low limit
Override/selective A normal target must yield to a limiting variable Selector direction, tracking and anti-windup Treating a selector as a safety function Smooth takeover and release at the operating limit
Decoupling Known interaction degrades paired loops Usable interaction model across range Exact cancellation assumed despite changing dynamics One setpoint change with reduced cross-effect
Inferential Property is delayed/expensive but correlated measurements exist Reconciled reference, uncertainty and validation Using a correlation outside its trained envelope Independent samples across feed/rate/mode range
MPC Several CVs/MVs interact and constraints matter Identifiable dynamics, degrees of freedom and valid limits Applying MPC to broken base loops Coordinated move reaches target without constraint violation
Real-time optimization Feasible targets should move with economics Reconciled model, current costs and target governance Sending an infeasible optimum directly to control Approved target change remains feasible through lower layers
Advanced process control strategy selection map comparing cascade feedforward ratio override inferential MPC and optimization by disturbance interaction and constraints
Strategy selection begins with the mechanism and evidence, not the software brand. Several plants need a disciplined regulatory repair before they need a larger optimizer.

Use a decision record rather than an algorithm wish list

For every proposed application, record the operating objective, present manual actions, manipulated degrees of freedom, controlled outcomes, measured disturbances, active limits, process modes, expected dynamic time scale, safety/environmental boundary, source of economic value and falsifiable acceptance test. Then compare candidate structures on performance, implementation effort, operator clarity and lifecycle burden.

Reject a design when it merely moves hidden complexity into custom scripts. A maintainable cascade or selector implemented in the approved BPCS can outperform an impressive but unsupported APC application. Conversely, dozens of interacting selectors and manual operator rules can be a strong signal that a constrained multivariable solution deserves a controlled pilot.

Prove APC readiness before model identification

Gate instruments, valves and base loops

An APC readiness review should use time-series evidence, maintenance history and controlled response tests. Check every candidate measurement for calibration state, engineering units, resolution, sample behavior, filtering, bad-value flags, delay, range and operating coverage. Check each valve or drive for deadband, stiction, saturation, travel limits, position feedback, rate limits and failure behavior. A model fitted to valve stiction may reproduce the test period while failing as soon as maintenance restores the valve.

For base loops, quantify mode availability, oscillation, variance, saturation, interaction and tuning. Confirm manual/auto and remote/local transitions, setpoint tracking, anti-reset windup, output initialization and bumpless transfer. Repair high-impact loops and repeat the observation period before promising APC value.

Readiness gate Minimum evidence Reject or remediate when Owner
Measurement Calibration/range/units, quality flags and trend coverage Bias, clipping, unresolved bad quality or excessive delay Instrumentation and process engineering
Analyzer/lab Timestamped sample alignment and representative validation Sample delay/handling or model bias is unknown Laboratory, analyzer and process owners
Final element Command, position/process response and maintenance condition Stiction, saturation or fail behavior defeats intended moves Control and maintenance
PID loop Mode, tuning, oscillation, saturation and disturbance response Loop spends material time manual or unstable Control engineer and operations
Data history Time alignment, gaps, compression and mode context Important transitions are erased or clocks disagree OT/data owner
Process degrees of freedom Independent MVs and feasible ranges Claimed MV is already pinned or controlled elsewhere Process and operations
Constraint definition Source, units, priority, margin and owner “Limit” is undocumented, contradictory or not measurable Process, equipment and safety owners
Operating modes Start-up, shutdown, grade/rate and equipment states One model silently spans incompatible dynamics Operations and APC engineer
Fallback Receiving logic, tracking, alarm and recovery procedure Loss of APC creates a bump or undefined target BPCS, operations and APC owners
Benefit baseline Normalized historical comparison and exclusions Value is only anecdotal or confounded by other changes Operations, finance and engineering

Confirm controllability, observability and safe excitation

MPC needs usable cause-and-effect information. An MV must influence at least one relevant CV within a time scale the application can identify and control. A CV must be measured or estimated with adequate quality. Independent MVs are required to satisfy independent objectives; three requested targets do not create three degrees of freedom when only one actuator is truly available.

Identification moves must be large enough to separate response from noise yet small enough to remain inside the approved operating envelope. Define step sizes, directions, hold times, simultaneous-move rules, abort limits, excluded modes and required staffing before the test. Production pressure is not authority to bypass management of change, operating procedures or independent protection.

Understand how constrained MPC makes a move

Define CVs, MVs and DVs without hiding ownership

A controlled variable (CV) is an outcome the controller should keep at a target, within a zone or away from a constraint. Examples include product composition, column pressure, furnace oxygen, compressor suction pressure or energy intensity. A manipulated variable (MV) is a target the MPC can move, commonly the setpoint of a proven base loop. A disturbance variable (DV) is a measured influence that the model uses for prediction but cannot command, such as feed rate, feed composition, ambient condition or upstream pressure.

Every variable needs more than a tag name. Retain engineering units, source, sample/update expectation, scale, quality definition, valid modes, low/high bounds, move-rate limits, priority, bad-data response, substitution rule and operator display. A temperature in degrees Celsius accidentally modeled as Fahrenheit is not a tuning problem. A flow total mistaken for a flow rate is not a small data-quality issue.

MPC object Distillation illustration Contract question Degraded response
CV: top composition estimate Purity target/low limit Is the inferential reconciled to current lab/analyzer evidence? Remove from optimization or fall back to conservative target
CV: column pressure Operating zone/high limit Is measurement fast, independent and linked to protection separately? Hold/disable affected moves; BPCS remains authoritative
CV: reboiler duty Economic penalty/high equipment limit Is calculated duty current and physically plausible? Drop economic objective; retain equipment limit elsewhere
MV: reflux-flow setpoint Adjusts separation and energy use Is the flow loop remote, healthy and not saturated? Track current SP; make MV unavailable
MV: steam-flow setpoint Adjusts vapor traffic and separation Are rate and absolute limits enforced in BPCS too? Freeze/return to approved base target
MV: product draw setpoint Changes inventory and quality dynamics Are level/material-balance interactions represented? Remove MV or switch controller to a reduced configuration
DV: feed rate Predicts load change Is it measured before its effect and time-aligned? Continue without feedforward only if tested and approved
DV: feed composition Predicts separation demand Is analyzer delay/quality explicit? Mark invalid and increase operating margin or disable model

Use prediction, objective and constraints as three separate contracts

For an educational linear MPC formulation, predicted future outputs can be summarized as:

Y = F x(k) + G ΔU + H D

where x(k) represents the current estimated state, ΔU the candidate future MV increments and D known/predicted disturbances. The controller selects ΔU to minimize an objective such as:

J = Σ ||Y - R||²_Q + Σ ||ΔU||²_R + ρ ||ε||²

subject to approved absolute MV bounds, MV move-rate bounds, CV limits and any model-specific restrictions. Q weights CV deviation, R discourages excessive movement and ε represents a permitted soft-constraint violation penalized by ρ. This notation explains the structure; it is not a vendor tuning recipe.

Constraint classification matters. A physical or safety-related boundary is not made safe merely by giving it a very large optimization weight. Decide which constraints are hard in the solver, which use explicit slack, which are enforced again in the BPCS, and which belong entirely to independent protection. Make infeasibility visible. Quietly relaxing every limit can produce a numerical solution while breaking the operating contract.

Choose horizons and execution from process dynamics

The prediction horizon must extend far enough to see the material consequences of candidate moves. The control horizon determines how many future moves are optimized independently. The execution interval must capture meaningful dynamics without reacting to measurement noise or consuming needless resources. Faster is not automatically better for a slow distillation composition response; slower is not acceptable when a relevant pressure interaction develops before the next calculation.

Validate the design across the fastest important controlled interaction, the slowest economically relevant response, dead time, analyzer delays and changing process modes. Inspect predicted versus actual response for each important MV–CV pair rather than relying only on an overall fit statistic.

Work through an advanced process control example

Define a hypothetical constrained distillation problem

Consider a fictional distillation unit producing 100 tonnes per hour. Operators must protect a top-product purity minimum, a column-pressure ceiling and a reboiler-duty limit while coordinating reflux, steam and product draw. Feed rate and feed composition change. Separate PID loops already control reflux flow, steam flow, column pressure and inventories, but operators frequently pull the throughput target away from constraints because interactions and delayed quality evidence make the true margin hard to judge.

The proposed MPC has three MVs: reflux-flow setpoint, steam-flow setpoint and throughput/product-draw target. Its CVs are a reconciled top-purity inferential, column pressure, reboiler duty and inventory-related operating zones. Feed rate and available composition information enter as DVs. The MPC can move only remote, healthy base-loop setpoints; BPCS limits and interlocks remain active. If the inferential fails validation, the quality CV becomes unavailable and the controller returns to a documented conservative operating target or disengages according to the mode design.

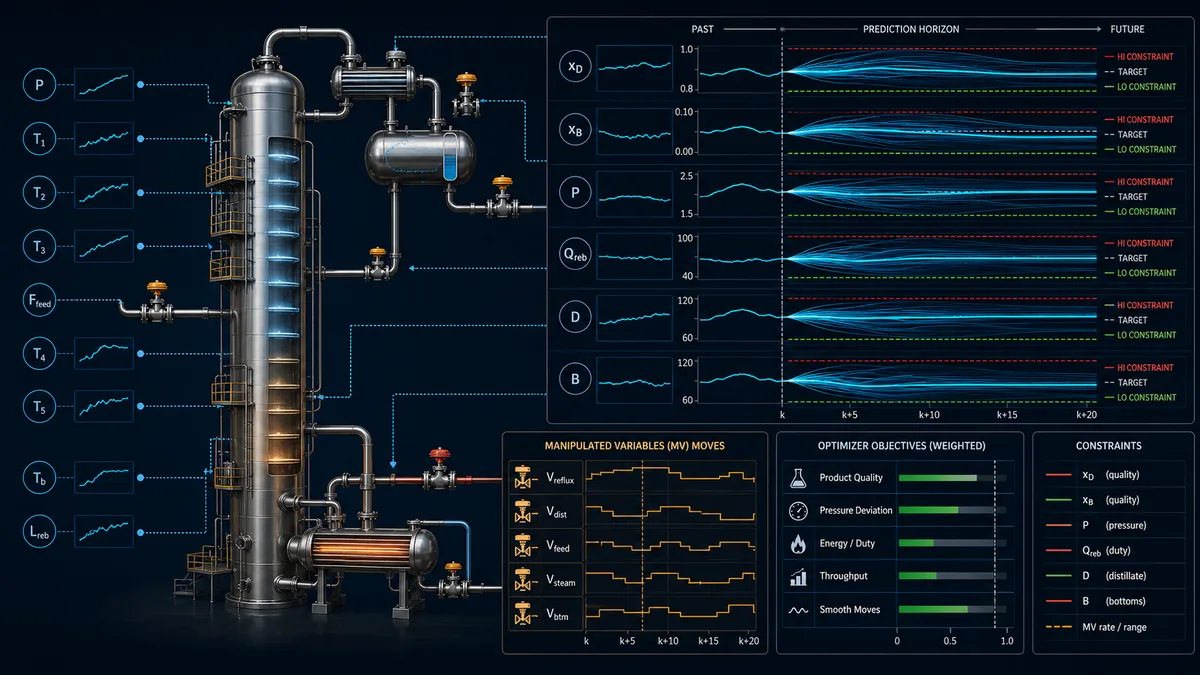

Model predictive control example for a distillation column coordinating reflux steam and product draw against purity pressure and reboiler constraints
The example exposes controlled, manipulated and disturbance variables plus fallback. It is a teaching model, not a design for a real column.
Variable Role Example normal objective Example constraint/eligibility Independent proof
Top-product purity inferential CV Stay above customer-quality target with measured margin Valid only inside reconciled model envelope Time-aligned lab/analyzer samples and residual trend
Column pressure CV Maintain operating zone High operating limit plus separate protection Calibrated pressure and approved test evidence
Reboiler duty CV Minimize energy for feasible production Equipment/process high limit Steam conditions and energy calculation audit
Reflux SP MV Coordinate separation Flow-loop remote/healthy; absolute and move limits SP/PV/output/valve response
Steam SP MV Coordinate vapor traffic Remote/healthy; equipment rate and absolute limits SP/PV/output plus process response
Production/draw SP MV Raise feasible throughput Inventory and downstream constraints available Material balance and receiving-unit capacity
Feed rate DV Predict load demand Valid range, quality and time alignment Independent balance/cross-check
Feed composition DV Predict separation difficulty Analyzer/sample delay and quality explicit Reference sample and timestamp reconciliation

Calculate a transparent illustrative business case

Suppose a controlled trial supports a sustained throughput change from 100 to 104 tonnes per hour during comparable eligible operation. At 8,000 eligible operating hours per year and an assumed contribution margin of $25/t, the illustrative gross contribution is:

4 t/h × 8,000 h/y × $25/t = $800,000/y

Suppose the higher operating point adds an average 0.2 MW of energy demand and the applicable energy cost is $70/MWh:

0.2 MW × 8,000 h/y × $70/MWh = $112,000/y

If annual software, support, model-maintenance and engineering cost is $180,000/y, the illustrative annual net is:

$800,000 - $112,000 - $180,000 = $508,000/y

For a fictional one-time implementation cost of $600,000, simple payback is:

$600,000 ÷ $508,000/y × 12 = 14.2 months

These numbers are deliberately transparent and hypothetical. They are not a forecast for another process or a claim about any software product. A real study should include product value by grade, yield, giveaway, energy/fuel, utilities, flaring/emissions where legitimately monetized, catalyst/equipment effects, maintenance, off-spec disposition, lost opportunity during testing, licensing, infrastructure, cybersecurity, training and ongoing model support. It should also test downside cases.

Sensitivity case Incremental throughput Margin Added energy cost Annual lifecycle cost Illustrative net/year Simple payback on $600k
Downside 2 t/h $20/t $160k $220k $320k - $160k - $220k = -$60k No positive payback
Base illustration 4 t/h $25/t $112k $180k $508k 14.2 months
Upside sensitivity 5 t/h $30/t $140k $180k $1.20m - $140k - $180k = $880k 8.2 months

Prove benefit with matched periods and availability

The controller cannot claim all improvement after its start date. Normalize for feed, rate, product grade, ambient conditions, equipment lineup, catalyst age, upstream/downstream constraints, planned maintenance and price assumptions. Define an eligible-period mask before comparing APC on/off results. Retain controller service factor, CV/MV availability, time at constraints, operator interventions and constraint violations alongside the economic measure.

A persuasive report separates gross opportunity, achieved technical effect, controller availability and monetization. For example, reduced variance may be technically real but have no economic value unless it permits a target shift, prevents giveaway, increases feasible rate or reduces consumption. Conversely, a throughput gain during a favorable feed campaign should not be booked entirely to APC.

Build and validate the dynamic model

Plan step tests as controlled plant experiments

Create a test matrix for each candidate MV. State its current range, proposed positive/negative move, expected affected CVs, approximate delay/settling time, constraints, excluded simultaneous changes, abort criteria and responsible console/field personnel. Log process mode, disturbances, operator actions, maintenance events and data-quality changes. Use sufficiently long holds to observe the relevant response; repeated short movements may excite only noise or fast base-loop behavior.

Do not force unsafe or economically reckless moves merely to improve identifiability. Historical data, designed tests, first-principles knowledge and hybrid approaches can be combined, but uncertainty must remain visible. If safe operation never excites an interaction, the model should not pretend that behavior is known far outside the observed envelope.

Advanced process control commissioning workflow from approved step test through response identification model validation shadow mode and constrained closed loop
Identification is a managed plant experiment. The path to closed loop includes independent validation, shadow observation, bounded authority and rollback evidence.

Validate models outside the fitting interval

Reserve representative periods that were not used to fit parameters. Compare predicted and measured direction, delay, initial slope, gain, settling shape and cross-variable response. Inspect residual bias and correlation with mode, rate or disturbances. A high aggregate fit can hide the wrong sign on an important interaction or a delay error that causes poor closed-loop moves.

Document the valid operating region and configuration: process mode, equipment lineup, base-loop tuning, valve condition, analyzer state, sample interval and model version. Use multiple models or explicit scheduling where modes genuinely differ. Do not silently average start-up, steady production and grade-transition dynamics into one controller.

Engineer mode, authority and operator handoff

Use explicit states instead of one ambiguous on/off bit

An APC application should expose why it can or cannot act. A practical state model may include OFF, READY, ADVISORY, CLOSED_LOOP, DEGRADED and RETURN_TO_BASE. The exact implementation varies, but transitions, permissions and outputs must be deterministic. “Solver running” is not equivalent to “every MV is available” or “economic optimization is active.”

READY can mean infrastructure, models, signals and base loops pass current eligibility checks. ADVISORY calculates predicted moves without writing them. CLOSED_LOOP permits bounded writes for eligible MVs. DEGRADED retains an approved reduced configuration after a noncritical variable is lost. RETURN_TO_BASE tracks the receiving setpoints/outputs and transfers authority through a documented rate-limited or bumpless sequence.

State APC calculation Writes allowed Operator evidence Exit condition
OFF Stopped or non-authoritative None Reason, last state and base targets visible Approved start plus all readiness gates
READY Current status/model checks may run None Eligible/ineligible CVs, MVs and DVs Operator/automation request to advisory or closed loop
ADVISORY Predictions and recommendations run None Proposed moves, predicted outcomes and constraint reason Acceptance to closed loop or loss of readiness
CLOSED_LOOP Repeated constrained optimization Bounded eligible MV targets Active objectives, constraints, moves, service factor Operator request, eligibility loss, fault or procedure
DEGRADED Approved reduced model/configuration Only documented subset Missing variable, reduced capability and consequence Restoration/revalidation or return to base
RETURN_TO_BASE Tracking and handoff logic Only controlled transition actions Target destination, rate and completion Base loop owns stable target; then OFF/READY

Design bumpless transitions and independent receiving limits

Before engagement, the APC's internal targets should track the actual receiving BPCS setpoints. On engagement, the first commanded value should equal or closely match the current value, followed by approved move limits. On disengagement, the BPCS retains the last acceptable setpoint or returns to a predefined operator/base target according to process risk. Integral action, selectors and remote/local modes need matching anti-windup and tracking behavior.

Enforce critical setpoint ranges and rates in the receiving control system as well as the optimizer. Network delays, stale calculations, configuration error or a compromised server should not allow an unbounded write. The BPCS should reject invalid quality, wrong mode, stale timestamp, implausible change or unauthorized source and should record the reason.

Advanced process control operator mode handoff with off ready advisory closed loop degraded and return to base states
Operator trust comes from visible eligibility, constraint reasons and a predictable return path—not from hiding complexity behind a green status indicator.

Give operators causes, consequences and permitted actions

The main display should answer: What is APC trying to achieve? Which CV is limiting? Which MV has freedom? Which variable was rejected and why? What move is being applied? What does the model predict? What happens if APC is taken out? Avoid flooding the console with every internal matrix value. Provide drill-down trends and model diagnostics for the support team.

Train with scenarios, not slides alone: an analyzer becomes bad, a valve saturates, one PID changes to local/manual, a process mode changes, a CV constraint conflicts with the economic objective, the APC server restarts, communication is lost and an operator deliberately returns to base control. Each scenario needs expected indications, authority, communication and recovery criteria.

Commission the application in controlled stages

Progress from offline evidence to bounded closed loop

A robust lifecycle separates installation success from control success. Build interfaces and models in an offline/test environment where possible. Replay historical and designed-test data. Run current calculations without writes in shadow/advisory mode. Compare predicted responses and proposed moves with process-engineer and operator expectations. Then close a limited subset of variables during a staffed approved window before expanding authority.

  1. Freeze the opportunity statement, owner, baseline, risk boundaries and acceptance criteria.
  2. Repair instrumentation, valves and base loops; repeat readiness measurement.
  3. Approve and execute identification tests with abort criteria and complete event logging.
  4. Fit models, reserve validation data and record valid modes/ranges.
  5. Configure CV/MV/DV definitions, limits, priorities, fallback and receiving-system enforcement.
  6. Perform offline replay, interface/failure tests and cybersecurity/change review.
  7. Run shadow/advisory mode through representative disturbances and operator shifts.
  8. Close a limited application with conservative move limits and active support.
  9. Challenge constraints, data loss, MV saturation, mode changes and return-to-base cases safely.
  10. Expand only after technical, operator and process acceptance; freeze the approved baseline.
  11. Measure normalized benefits and controller service factor over a representative period.
  12. Transfer maintenance ownership, diagnostics, backups, model-monitoring limits and revalidation triggers.

Define a test matrix that can fail meaningfully

Acceptance case Controlled stimulus Required evidence Example pass definition to tailor
Initial engagement APC tracks current base targets, then closes MV target/output and CV trends No material bump; every first move within approved limit
Measured disturbance Safe representative feed/load change DV timing, predictions, MVs, CVs Response direction correct and constraints maintained
CV approaches limit Approved target/disturbance near operating bound Active-constraint reason and competing targets Controller backs away with defined priority
MV saturates Use safe approved limit or simulated interface case MV availability, anti-windup/tracking, redistribution No repeated impossible request; other MVs act only as modeled
Bad CV/DV quality Simulate quality flag in test path Eligibility, operator message and fallback Variable removed/substituted only by approved rule
Base loop leaves remote Change approved test loop mode Write rejection, APC state and BPCS behavior MV becomes unavailable; handoff has no bump
Communication/server loss Controlled test environment or window Stale-write rejection and base-control state BPCS retains approved control; event is visible and recoverable
Restart/recovery Restart approved component version/model/config checks and tracking No automatic unreviewed closed-loop resumption
Return to base Operator requests disengagement tracking, target rate and final authority Stable base ownership with documented final targets
Benefit trial Predetermined matched on/off or staged comparison eligible periods, confounders and normalized KPIs Effect and uncertainty meet pre-agreed decision rule

Preserve configuration and rollback evidence

Archive the deployed models, variable contracts, unit/scaling maps, execution interval, constraint values, priority/weight configuration, interface configuration, server/application version, BPCS receiving logic, operator displays, test results, known limitations and approval record. Backups are not credible until a controlled restoration or independent comparison demonstrates they can recreate the intended state.

Rollback is more than uninstalling software. It defines who returns targets, how retained values are handled, which server writes are disabled, how the BPCS configuration is restored, how operators confirm authority and how post-change process behavior is observed.

Protect data and model health after go-live

Monitor input credibility before controller performance

APC degradation often begins outside the solver. Track missing/bad/flatlined/clipped measurements, timestamp skew, analyzer validation residuals, valve travel and stiction indicators, base-loop mode and saturation, MV availability, model prediction error and operation outside the identified range. A controller that is available but running on biased data is not healthy.

Use a hierarchy: input and base-control health; model residuals; controller eligibility/service factor; move behavior; CV variance/constraint performance; normalized process/economic outcomes. This order prevents teams from retuning weights to compensate for a biased transmitter or damaged valve.

Advanced process control health dashboard linking measurement quality valve and PID health model residuals controller availability and economic outcome
Model residuals are interpreted only after source measurements, final elements, regulatory loops and operating mode are credible.

Define revalidation triggers before performance decays

Trigger review after feedstock or grade changes, major maintenance, equipment modifications, sensor/analyzer replacement, valve work, BPCS tuning changes, tag/scaling changes, APC or operating-system upgrades, control-network changes, sustained residual drift, repeated operator disengagement or a shift in the active constraint pattern. Some events need only confirmation; others require new identification and model work.

Health signal Possible interpretation First evidence Wrong first response
One CV residual develops steady bias Sensor/inferential bias or unmodeled operating shift Independent reference and mode/feed correlation Increase CV weight
Oscillation appears in several predictions Base-loop oscillation, interaction or execution mismatch PID/MV trends and timing Shorten horizon blindly
MV requested at limit continuously True active constraint, lost degree of freedom or wrong target Physical/BPCS limit, valve state and objective Increase MV high limit without approval
Controller service factor falls Eligibility, operator trust, bad data or mode coverage issue Reason-code Pareto and shift/event timeline Report only total uptime
Benefit erodes while control metrics look stable Economics/baseline changed or target shift no longer valuable Normalized outcome and current value assumptions Claim original benefit indefinitely
Operators repeatedly switch off after certain moves Display, model, tuning or operational conflict Interview plus move/prediction/process trace Remove operator authority or retrain only
Prediction error increases after turnaround Equipment/configuration dynamics changed Pre/post asset, tuning and response comparison Reuse old model without validation
APC status is green but quality is off-spec Wrong CV/reference, delayed analyzer or eligibility gap Raw quality evidence and timestamps Treat green status as end-to-end proof

Select advanced process control software by lifecycle capability

Evaluate the complete engineering and operating workflow

Advanced process control software should be evaluated against the actual application: regulatory/sequence integration, historian and analyzer interfaces, data reconciliation, identification, model structure, constraint handling, inferentials, offline simulation, shadow mode, online deployment, operator displays, reason codes, version control, access control, backup/restore, monitoring, model maintenance, high availability, support and licensing. A polished optimizer is not sufficient if the site cannot diagnose why one MV is unavailable at 02:00.

Run a proof of fit with representative tags, dynamics, failure states and user roles. Require the vendor/integrator to demonstrate quality loss, timestamp problems, saturation, mode change, solver failure, server restart, version rollback and reduced-configuration behavior—not only a nominal closed-loop response.

Advanced process control software architecture connecting process data model engineering constrained optimizer operator interface BPCS and lifecycle monitoring
Software selection covers the full data-to-decision-to-operations lifecycle. Interfaces, reason codes, restoration and sustainment deserve the same scrutiny as the optimizer.
Capability Proof-of-fit question Acceptance evidence Lifecycle risk if weak
Data connectivity and quality Can it preserve source timestamps, quality, units and mode context? Representative good/bad/stale/out-of-order cases Plausible calculations from invalid data
Identification/modeling Can engineers inspect responses and validation residuals? Held-out dataset and versioned model report Black-box model cannot be defended or maintained
Constraints/infeasibility Are hard, soft and prioritized limits explicit? Deliberately conflicting test objectives Hidden relaxation or unexplained controller drop
Reduced configurations Can control continue safely after selected variables fail? CV/MV loss matrix and observed transitions One failure disables everything or silently changes authority
Operator experience Are objective, active constraint, moves and off reasons visible? Console walkthrough with abnormal scenarios Low trust and avoidable service-factor loss
BPCS integration Are writes bounded, tracked, quality-gated and audited? Interface and loss/restart tests Bumps, stale writes or undefined target ownership
Version/rollback Can exact models/configuration be compared and restored? Controlled restore to test environment Unrecoverable drift and slow incident response
Monitoring Can reason codes, residuals, saturation and value KPIs be trended? Health dashboard and alert workflow Slow degradation remains unnoticed
Cybersecurity Are identities, roles, services, logs and updates manageable? Architecture/threat/change review Excessive privilege and unmanaged attack surface
Commercial/support fit What licensing, infrastructure, skills and response are required? Total-cost/support scenario over lifecycle Business case omits recurring burden

Treat current vendors as candidates, not a universal ranking

As of the review date, official pages from Honeywell, AspenTech, AVEVA and KBC describe APC/MPC and process-optimization offerings. ABB and Emerson publish process-control and predictive-control capabilities within their ecosystems, while MathWorks documents MPC design, simulation and deployment tooling. Product scope, names, platform requirements and licensing can change. Their presence here establishes a market category, not an endorsement or a claim that the products are equivalent.

Shortlist from site architecture and support reality. An installed DCS ecosystem may make native integration attractive; a cross-platform estate may prioritize open, documented interfaces; a research or embedded application may need different modeling/deployment tools. Score every candidate against one common requirements matrix and a matched pilot. Keep vendor benefit statements attributed to the vendor until the site independently validates them.

Troubleshoot APC from the first failed evidence boundary

Capture the state before switching or retuning

When performance deteriorates, preserve the timeline: process mode, controller state, eligible CV/MV/DV set, active constraints, objective terms, predictions, applied moves, raw measurements and quality, base-loop modes/outputs, valve positions, analyzer/lab results, alarms, operator actions, model/configuration versions and recent changes. A reset can remove the evidence that separates a bad input from solver, interface or process problems.

Start at the process and data foundation, then move through model and optimizer to the receiving BPCS and physical response. If the optimizer requests the correct bounded setpoint but the PID loop is saturated, the APC solver is not the first failed boundary. If the BPCS receives no new target, investigate eligibility, calculation, communication and write permissions before blaming a valve.

Symptom Plausible causes Highest-value next check Avoid
APC will not enter closed loop Readiness bit, bad data, base-loop mode, permission or model configuration Explicit ineligible reason for every CV/MV and interface health Toggling enable repeatedly
APC enters then drops out Constraint conflict, quality transition, stale data, write rejection or solver event Time-aligned state/reason and calculation log Increasing every tolerance
Moves are directionally wrong Model sign/index/unit error, wrong tag, mode change or unmeasured disturbance Step-response record against live source-to-destination trace Retuning weights before verifying mapping
Moves are too aggressive Gain/delay mismatch, move penalty/limit, execution interval or base-loop change Predicted versus measured response and actual rate limits Depending on operator intervention as the normal limiter
Moves are too timid Active constraint, unavailable MV, excessive penalty, model uncertainty or no economic drive Objective/constraint contribution and degrees of freedom Raising limits without process approval
CV prediction drifts Sensor/inferential bias, model aging, unmodeled disturbance or mode mismatch Independent measurement and residual by operating condition Refitting before fixing biased data
One MV chatters noisy CV/DV, execution/tuning, valve stiction or competing controller raw/filtered signals, PID output and valve position Adding filter until the symptom disappears
APC says active but no value appears Objective not shifted, limiting constraint elsewhere, low availability or poor baseline matched eligible-period effect and constraint/activity distribution Repeating the original business-case promise
Operators disable APC unexplained moves, false alarms, bad handoff, wrong objective or workflow burden shift interviews plus preceding move/state trends Treating all disengagement as resistance to change
Restart changes targets missing tracking, retained state, version mismatch or auto-resume logic startup sequence, deployed checksum and receiving setpoints Allowing automatic writes before readiness review

Diagnose constraint and model problems separately

A controller legitimately held at a constraint may show a persistent target error. That is not necessarily bad tuning: the feasible solution cannot satisfy every target. Show the active constraint, priority and sacrificed objective to operators. If the claimed constraint is not physically active, trace units, scaling, tag mapping, limit source and configuration version.

A model problem appears as persistent or structured prediction error after input data and mode are proven. Inspect individual response pairs, not only an aggregate score. Re-identification may be warranted after equipment or operating changes, but a new model must pass the same held-out validation, shadow and fallback tests as the original.

Keep safety, process-risk and cybersecurity boundaries explicit

Treat APC changes through the site's process-safety lifecycle

In US-covered processes, OSHA's Process Safety Management rule includes management-of-change requirements for changes to process chemicals, technology, equipment, procedures and facilities, subject to the rule's scope and exceptions. APC projects can change targets, operating envelopes, modes, procedures, alarms and how people interact with the process. Determine applicability with the site's competent process-safety/legal authority; do not assume “software only” means no MOC.

Document technical basis, safety/health effects, required procedure changes, duration, authorization and training. Review hazard analyses and alarm/interlock implications. Verify that BPCS and SIS functions, trip settings, relief design assumptions, equipment limits and environmental constraints remain valid for the new operating region. APC may keep operation closer to a normal constraint; it must not consume undocumented safety margin.

Preserve independent protection and safe work practices

An optimization constraint is not an SIS function, relief device or mechanical design limit. The solver, network, server and ordinary measurements can fail. Independent protection must remain engineered and tested for its required role. Any field test, valve movement, instrument work or control change must follow approved isolation, hazardous-energy, electrical, process and environmental procedures.

The simulator practice link on this page is deliberately bounded to a deterministic educational PID process. It cannot validate a commercial MPC model, real process constraints, plant dynamics, SIS independence, relief capacity or safe operating limit.

Secure the APC data and write path as OT

NIST SP 800-82 Rev. 3 frames OT cybersecurity around operational performance, reliability and safety. Inventory APC servers, engineering stations, historians, interfaces, model repositories, operator clients and receiving control endpoints. Segment allowed flows, use named least-privilege identities, restrict configuration and writes, protect time sources, log changes and write attempts, manage remote access, test backup/restoration and evaluate updates in a representative environment.

Security boundary Control objective Validation case
APC-to-BPCS write path Only authenticated/authorized source, tags, modes, ranges and rates Unauthorized, stale, bad-quality and out-of-range writes are rejected/logged
Engineering/model repository Approved people can change versioned models/configuration Compare deployed checksum, approval and rollback copy
Data sources/time Measurements retain identity, quality and credible timestamps Bad/stale/skewed data invokes designed eligibility response
Remote/vendor support Explicit approved route, duration, identity and monitoring Access enable/use/disable evidence and session review
Server/client hardening Necessary services and roles only, managed changes Baseline comparison and recovery test after update
Backup and recovery Recreate known approved application without unsafe auto-resume Restore in test path, verify configuration, track targets before writes
Monitoring Detect service, data, model and authorization anomalies Alert-to-triage exercise linked to APC operating evidence

Sustain benefits as an operating system

Assign named ownership and a review cadence

Sustainment needs an operations sponsor, process engineer, control/APC engineer, instrumentation/maintenance owner, OT/platform owner and economic KPI owner. Define daily or shift review for off reasons and constraints, weekly review for availability/data/base-loop health, monthly review for model residuals and normalized technical value, and periodic governance for models, cybersecurity, licenses, training and business assumptions. Scale cadence to process criticality and change rate.

Do not reward the team for APC uptime alone. A controller can remain on while delivering no value or operating on weak data. Balance service factor with eligible-variable availability, constraint performance, base-loop/valve health, prediction error, operator interventions, quality/yield/rate/energy outcomes and incidents or limit excursions.

Advanced process control benefit sustainment loop connecting health monitoring operator review model maintenance normalized value and controlled revalidation
APC value is maintained through recurring evidence and ownership. The lifecycle loops back through data, base control, model and operating assumptions after every material change.

Use an evidence scorecard rather than one promised savings number

Scorecard layer Example measures Decision it supports
Foundation measurement availability, analyzer reconciliation, valve stiction, PID auto/remote time Is the control foundation still credible?
Controller health APC service factor, eligible CV/MV count, off-reason Pareto, solver/interface events Can the application exercise its intended authority?
Model health CV residual bias/variance, pairwise response exceptions, operation outside envelope Does the model still represent current operation?
Control effect CV variance, target shift, constraint time/violations, MV movement/saturation Is APC changing technical behavior as designed?
Operator use intentional disengagement, unplanned overrides, transition success, support calls Is the workflow understood and trusted?
Process value normalized throughput, yield/giveaway, energy, quality, emissions or equipment metric Does technical effect create attributable value?
Risk/lifecycle MOC completion, incidents, patches, backup tests, model/version review Is value being delivered within the approved lifecycle?

Practise the foundation without overstating the simulator

Use PID process practice to strengthen the base layer

The PID process simulator provides a deterministic first-order process in which learners can change gains, observe overshoot, settling, final error and integrated absolute error, and compare disturbance cases. That is useful preparation for APC because higher layers depend on stable, understandable regulatory behavior.

The browser lab is not commercial advanced process control software. It does not identify or commission a multivariable MPC, represent a real distillation column, validate plant constraints, connect to a DCS, or replace process/safety engineering. Use it to rehearse measurement, feedback, saturation and disturbance reasoning; then validate models, limits, handoff and fallback in the approved APC/DCS environment with qualified site personnel.

Follow a staged APC training path

  1. Prove instrumentation scaling, quality and failure states.
  2. Tune and diagnose first-order PID behavior, including saturation and disturbance response.
  3. Build cascade, ratio, feedforward and override examples in an approved lab environment.
  4. Learn dynamic response, dead time, interaction and degrees of freedom from controlled data.
  5. Formulate CV/MV/DV contracts and hard/soft constraint decisions.
  6. Simulate a multivariable controller offline and validate against held-out scenarios.
  7. Practise advisory/closed-loop/degraded/return-to-base transitions.
  8. Review a real application under site MOC, cybersecurity, operator and safety governance.

Diagnostic answer map for advanced process control queries

APC versus PID in one decision

Use PID and advanced regulatory structures when a small number of loops can reject disturbances and respect limits transparently. Use MPC when several controlled and manipulated variables interact, future response matters and explicit constraints must be coordinated. In either case, repair measurements, final elements and base loops first; MPC normally supervises those loops rather than replacing them.

The evidence needed before an APC project

Start with time-aligned measurement quality, valve/drive response, base-loop modes and performance, independent degrees of freedom, documented constraint ownership, representative operating modes, safe test authority, a bounded BPCS write contract, predictable fallback and a normalized economic baseline. A model-development milestone should not override a failed readiness gate.

The meaning of a constrained MPC move

The controller predicts how eligible CVs will respond to candidate MV moves and measured DVs, then chooses a bounded move sequence that balances target deviation, movement and permitted soft-constraint slack. Only the first move is applied before the calculation repeats. Hard solver constraints, receiving-system limits and independent protection remain separate contracts.

The first evidence to inspect when APC performs badly

Capture the operating mode, CV/MV/DV eligibility, active constraints, prediction, requested and applied moves, raw signal quality, base-loop state, final-element response and recent configuration changes before reset. Find the first mismatch from physical process and data through model, solver, interface, BPCS and process response before retuning weights.

The software-selection answer

Select against the whole lifecycle: data quality, identification, held-out validation, constraint behavior, reduced configurations, shadow testing, operator reason codes, bounded control-system integration, version/rollback, health monitoring, cybersecurity, support and total cost. Demonstrate abnormal states using representative data; do not infer operational fit from a nominal optimizer demo.

Frequently asked questions

What is advanced process control and how is it different from PID control?

Advanced process control is an umbrella for strategies beyond ordinary independent feedback loops, including cascade, feedforward, ratio, override, inferentials and multivariable MPC. PID commonly regulates one primary variable; MPC predicts several interacting variables and selects constrained moves. APC normally supervises proven PID loops rather than replacing them.

Which control strategies count as advanced process control?

Usage varies by organization. Advanced regulatory control commonly includes cascade, feedforward, ratio, selective/override and decoupling strategies. Broader APC programs add inferential measurements, MPC and an interface to real-time optimization. Always state the actual method instead of assuming the label APC defines one algorithm.

When should a plant use cascade, feedforward, ratio control, MPC or real-time optimization?

Use cascade for a faster measurable secondary disturbance, feedforward for an early measured disturbance, ratio for proportional quantities and override for a limiting variable. Consider MPC when several CVs and MVs interact and explicit constraints matter. Consider real-time optimization when economically preferred feasible targets should change with costs and process conditions.

What prerequisites are needed before an APC project?

Prove calibrated and time-aligned measurements, responsive final elements, stable base PID loops, usable degrees of freedom, documented operating constraints, representative data, separable process modes, safe identification authority, BPCS write limits, operator ownership, fallback and a normalized benefit baseline. Repair failed gates before model building.

How do I calculate the business case for advanced process control?

Define an attributable technical change, eligible operating hours and value per unit; deduct incremental energy, quality, maintenance, licensing, infrastructure and support. Include implementation cost and downside sensitivity. After deployment, use matched or normalized periods and controller availability rather than assigning every post-start improvement to APC.

What is a practical advanced process control example?

A distillation MPC can coordinate reflux, steam and production targets to keep purity, pressure, energy and inventories inside constraints while responding to feed changes. The example on this page shows the CV/MV/DV contract and a disclosed hypothetical business calculation. A real design requires plant-specific models, limits and safety review.

How is model predictive control commissioned and constrained safely?

Commission through readiness repair, approved identification, held-out model validation, offline replay, shadow/advisory operation, conservative limited closure and safe failure/recovery tests. Separate hard and soft optimization constraints, enforce critical ranges/rates again in the BPCS, and retain independent protective systems and approved management of change.

What data quality problems cause advanced process control to fail?

Bias, wrong units/scaling, stale or misaligned timestamps, excessive compression, clipped or flatlined signals, analyzer/sample delay, unmarked bad quality, valve stiction, base loops in manual and mixed operating modes can all invalidate predictions. Monitor those foundations before retuning the optimizer.

How do operators take an APC application in and out of service?

Use explicit eligibility and states such as ready, advisory, closed loop, degraded and return to base. Track actual BPCS targets before engagement, apply bounded first moves, show active constraints/off reasons, and execute a documented bumpless handoff that leaves base control with known stable targets.

Which advanced process control software capabilities matter during selection?

Evaluate connectivity and data quality, identification and held-out validation, hard/soft constraints, reduced configurations, offline/shadow testing, operator reason codes, bounded BPCS integration, versioning/rollback, monitoring, cybersecurity, support and lifecycle cost. Run matched abnormal-condition tests with representative data instead of selecting from a feature list alone.

Sources, review scope, and limitations

Primary and authoritative sources used for this guide

Review and safety limitations

This guide is a vendor-neutral educational framework. It is not an APC/MPC design specification, process model, constraint authority, tuning file, software recommendation, independent benefit study, cybersecurity architecture, HAZOP/LOPA, relief or equipment-limit assessment, SIS design, MOC approval, operating procedure or field-test authorization. The equations and distillation/business examples are intentionally simplified; the $508,000/y net and 14.2-month payback are fictional arithmetic, not observed product or customer results.

The nine original generated visuals are explanatory abstractions. They do not establish piping, instrument, network, solver, model, constraint, alarm, trip or operator-interface design. Product names and official vendor capability pages were reviewed on the date above; verify current names, releases, dependencies, security support, licensing and compatibility with each vendor.

Use qualified process, control, instrumentation, operations, maintenance, safety, cybersecurity and financial personnel; current plant documentation and process-safety information; approved safe operating limits and independent protection; representative data and controlled tests; and site change, access, isolation and recovery procedures. Revalidate after changes to feed/grade/rate, equipment, instruments/analyzers, valves/drives, PID tuning/modes, tags/scaling/time, model/constraints/objectives, APC/DCS/interface software, network/identity, operating procedures, safety/environmental assumptions or economic basis.

PPI

PLC Programming IO Editorial Team

Industrial automation education, references, and software testing

Sources TrackedVersions RecordedCorrections Accepted

The PLC Programming IO Editorial Team publishes sourced industrial-automation education and documents how material is reviewed, tested, and corrected. A team byline means the publisher is responsible for the page; it does not represent a fictional person or imply an engineering licence.

Coverage:

  • • PLC programming concepts and examples
  • • Vendor software tutorials and comparisons
  • • SCADA, HMI, protocols, and instrumentation
  • • Training, careers, and reference material

Review standard:

  • • Prefer primary and official sources
  • • Record software versions when material
  • • Separate tested facts from estimates
  • • Publish material corrections

Important scope note

This site provides education, not project-specific engineering approval. Safety, code, and compliance decisions require a qualified person with access to the actual machine and jurisdiction.
